The Bryntum Gantt engine optimizes task scheduling by placing tasks as early as possible (ASAP) within a project
timeline; this is true for forward-scheduled projects only, which is the default case. For a backward-scheduled project,
scheduling happens as late as possible (ALAP). Unpinned tasks automatically align with the startDate of their parent
task or project, while the engine accounts for any dependencies and constraints to ensure accurate scheduling.
It also excludes any manually scheduled or inactive tasks.
This guide helps you understand these concepts in detail, ensuring there is no confusion about task scheduling.
Tasks can be either automatically (default) or manually scheduled. This is defined by the
manuallyScheduled task flag.
You can exclude any task from the scheduling process by deactivating it. To do this, set the task's
inactive field to true. Inactive tasks neither push their linked tasks nor add
their attributes to parent tasks.
Tasks that are manually scheduled (manuallyScheduled) are not affected by
the automatic rescheduling process, they are meant to be adjusted manually by a user.
It is also possible to treat started tasks as manually scheduled if their start dates are already determined and should not be auto-calculated.
Configure this behavior using the startedTaskScheduling field.
One of the most common questions is why tasks of my app are moved to the project's start? It's because of
automatic task scheduling.
The Gantt scheduling engine updates the start and end dates of automatically scheduled tasks based on their
constraints, links and position in the task hierarchy.
It means that the startDate and endDate are revalidated and
may be recalculated as soon as the task is added or loaded to a project.
When auto-scheduling, the Gantt engine checks if a task has any predecessors or constraints and schedules
accordingly. If it has none, it will be scheduled as early as possible, which is at the project's start.
You may also want to check autoSetConstraints, enabling this config results in
auto constraints to the tasks, showing your task based on the startDate and
endDate, if no constraints or dependencies affects it.
In a forward-scheduled project (default), the Gantt engine schedules tasks as soon as possible (ASAP).
For such projects, the start date is mandatory and sets an implicit
Start no earlier than constraint (see constraint details in the below chapters)
inherited by all tasks. It means any task with no restrictions will fall back to that date.
The end date of a forward scheduled project is a calculated value equal to the latest
end date of its tasks.
In a backward scheduled project, the Gantt engine schedules tasks as late as possible (ALAP).
In such a project, the end date value is mandatory and the
start date is calculated as the earliest start date of the
project tasks. The project end date creates an implicit
Finish no later than constraint inherited by all tasks.
It means that any task with no restrictions will fall back to finish on that date.
When a task changes, the Gantt engine will automatically reschedule its linked tasks.
In forward-scheduled projects, successors react to their predecessor's changes and in backward-scheduled projects,
the predecessors respond to changes made in their successors.
How dependent tasks will be updated after a modification depends on the
dependency type.
The Gantt engine supports the following four types of dependencies:
The default type of a dependency is "Finish-to-Start" (FS). This type of dependency restricts the dependent task
to not start earlier than the end date of the preceding task.
Lead (or "negative lag") will accelerate the succeeding task by the number of time units specified.
The lag value specifies the amount of working time. The
calendar controlling which time to use is defined by the calendar field. By
default, the successor calendar is used.
A task constraint defines boundaries for the schedulable date range of a task, and it is taken into account
when the engine schedules the project tasks.
A constraint is a combination of two task properties: constraintType and
constraintDate.
The date range specified by a constraint restricts the task start/end dates to be not earlier than,
not later than or equal to the provided constraintDate.
As mentioned above, a task with no restrictions is scheduled for the project start for forward projects
(and on the project end date for backward projects). When a user manually drags a task in a Gantt chart,
the Gantt enforces the position by setting a constraint on the task.
In a forward scheduled project, it uses:
There are two constraint types in this group: Must start on (MSO) and
Must finish on (MFO).
They force a task to start/finish exactly on the date provided.
These constraints share the same priority with task dependencies. They all work together respecting the task working
time:
Start no earlier than (SNET) - restricts the task to start on or after the
specified date.
Finish no earlier than (FNET) - restricts the task to finish on or after the
specified date.
Start no later than (SNLT) - restricts the task to start before (or on) the
specified date.
Finish no later than (FNLT) - restricts the task to finish before (or on) the
specified date.
Effectively, the task start/end dates are calculated as aggregated values considering dependencies
and such constraints. The earliest start date for a task is computed as the latest of the earliest start allowed by
its constraint and the earliest start allowed by its dependencies.
An example, Event A has two incoming dependencies which don't allow it to start earlier than 01/18/2017 and the task
has a SNET constraint which forces it to start not earlier than 01/17/2017. In this case, the resulting earliest
start date of the task is 01/18/2017. If we change the constraint date to 01/19/2017 the resulting earliest start
date will be 01/19/2017.
When scheduling tasks, the Gantt engine takes the hierarchy into account by following these two principles:
Each task inherits its parent (summary) task restrictions (dependencies and constraints).
A summary task start date and end date should match the minimum
start date and maximum end date of its children respectively. Its
effort equals the sum of the effort values of all its children.
The % completed value of a parent task is calculated based on its children's progress. It
is determined by dividing the sum of each child's completed duration by the total duration of all children. The
completed duration for each child is obtained by multiplying its individual percentage completion value by its duration.

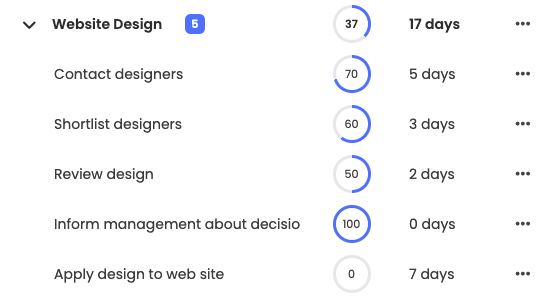

To explain this more, consider the following example:
It has the following values:
Cell
Duration
Complete Duration
Contact designers
5
350
Shortlist designers
3
180
Review design
2
100
Inform management...
0
0
Apply design...
7
0
Sum of all
17
630
Next, divide the sum of the complete duration by the sum of the duration
(630/17), which will result in 37%.
Following the above rules, the Gantt engine recalculates summary tasks when their children are updated. The same
goes for the reverse case, child tasks will react to changes to constraints and dependencies of their parents.
Unlike the dependencies and constraints affecting the task position on the time axis,
the scheduling mode specifies how the task's properties depend on each other.
It defines which properties are fixed (provided by the user) and which should be calculated.
There is also an additional effortDriven flag allowing to fix
the task effort value. When set, it tells the task to preserve its effort
value and instead recalculate other properties.
In the Normal mode (default), the task is scheduled based on information about its start/end dates.
The task effort and assignments are not calculated in this mode.
Fixed Duration mode means that the task has fixed start and end dates
and duration, but its effort is computed dynamically
based on the assigned resources.
A typical example of such a task is a meeting. Meetings typically have pre-defined start and end dates, and the
The more people participating in the meeting, the more effort is spent on the task.
When the duration of such a task increases, its effort increases, too.
Changes to the effort of such a task will cause assignment units recalculation and vice-versa
(assignments change will cause recalculation of the effort).
Enabling effortDriven for a task will change that behavior and force the task to
always recalculate its assignment units whenever the task changes its duration or
effort.
Calculations provided by this mode work only if the task has at least one resource assigned.
Fixed Effort mode means that the task has a fixed effort and computed
duration.
The more resources are assigned to the task, the less the duration will be.
A typical example is a "paint the walls" task - several painters will complete it faster.
Enabling the effortDriven flag makes no sense in this mode.
Calculations provided by this mode work only if the task has at least one resource assigned.
Gantt task scheduling
The Bryntum Gantt engine optimizes task scheduling by placing tasks as early as possible (ASAP) within a project timeline; this is true for forward-scheduled projects only, which is the default case. For a backward-scheduled project, scheduling happens as late as possible (ALAP). Unpinned tasks automatically align with the startDate of their parent task or project, while the engine accounts for any dependencies and constraints to ensure accurate scheduling. It also excludes any manually scheduled or inactive tasks.
This guide helps you understand these concepts in detail, ensuring there is no confusion about task scheduling.
Scheduling
Tasks can be either automatically (default) or manually scheduled. This is defined by the manuallyScheduled task flag.
You can exclude any task from the scheduling process by deactivating it. To do this, set the task's inactive field to
true
. Inactive tasks neither push their linked tasks nor add their attributes to parent tasks.Manually scheduled tasks
Tasks that are manually scheduled (manuallyScheduled) are not affected by the automatic rescheduling process, they are meant to be adjusted manually by a user.
It is also possible to treat started tasks as manually scheduled if their start dates are already determined and should not be auto-calculated. Configure this behavior using the startedTaskScheduling field.
Automatic task scheduling
One of the most common questions is why tasks of my app are moved to the project's start? It's because of automatic task scheduling.
The Gantt scheduling engine updates the start and end dates of automatically scheduled tasks based on their constraints, links and position in the task hierarchy. It means that the startDate and endDate are revalidated and may be recalculated as soon as the task is added or loaded to a project.
When auto-scheduling, the Gantt engine checks if a task has any predecessors or constraints and schedules accordingly. If it has none, it will be scheduled as early as possible, which is at the project's start.
You may also want to check autoSetConstraints, enabling this config results in auto constraints to the tasks, showing your task based on the startDate and endDate, if no constraints or dependencies affects it.
Project direction
The Gantt engine supports both forward and backward scheduling, controlled by the project direction config.
Forward scheduled project
In a forward-scheduled project (default), the Gantt engine schedules tasks as soon as possible (ASAP). For such projects, the start date is mandatory and sets an implicit Start no earlier than constraint (see constraint details in the below chapters) inherited by all tasks. It means any task with no restrictions will fall back to that date.
The end date of a forward scheduled project is a calculated value equal to the latest end date of its tasks.
Backward scheduled project
In a backward scheduled project, the Gantt engine schedules tasks as late as possible (ALAP). In such a project, the end date value is mandatory and the start date is calculated as the earliest start date of the project tasks. The project end date creates an implicit Finish no later than constraint inherited by all tasks. It means that any task with no restrictions will fall back to finish on that date.
Propagating changes through task dependencies
When a task changes, the Gantt engine will automatically reschedule its linked tasks. In forward-scheduled projects, successors react to their predecessor's changes and in backward-scheduled projects, the predecessors respond to changes made in their successors.
How dependent tasks will be updated after a modification depends on the dependency type. The Gantt engine supports the following four types of dependencies:

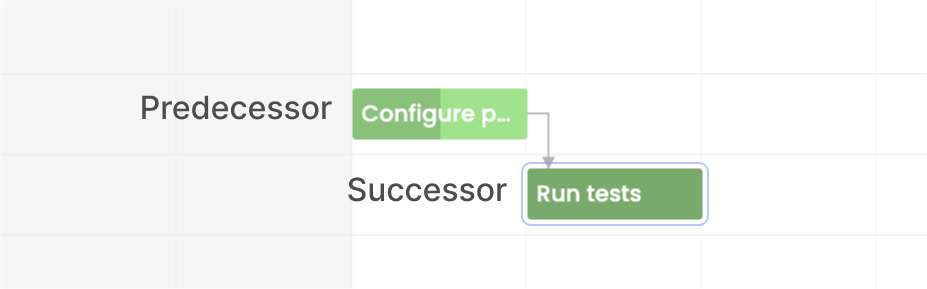

Finish-to-Start
The default type of a dependency is "Finish-to-Start" (FS). This type of dependency restricts the dependent task to not start earlier than the end date of the preceding task.

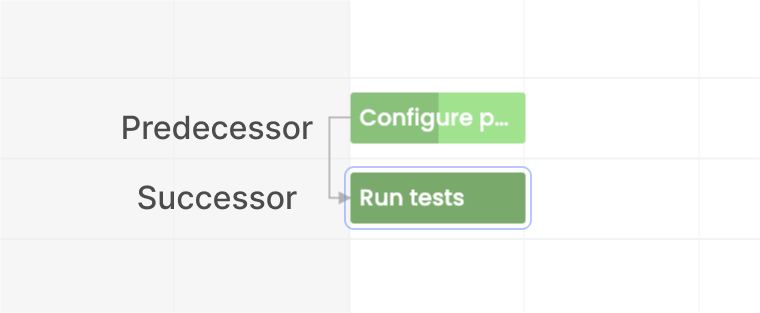

Start-to-Start
With this dependency type, the succeeding task is delayed not to start earlier than the start of the preceding task.

Finish-to-Finish
The succeeding task cannot finish before the completion of the preceding task.

Start-to-Finish
The finish of the succeeding task is constrained by the start of the preceding task. The successor cannot finish before the predecessor starts.
Dependency lead and lag

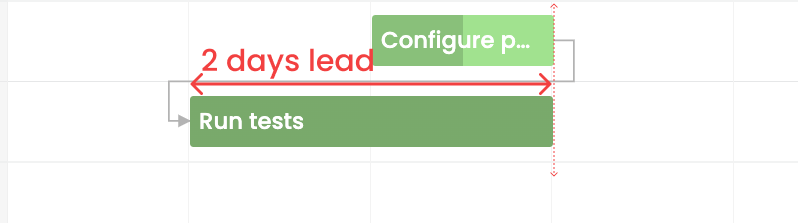

A dependency can have a lag (or lead) value which can delay the succeeding task by the number of lag units specified.

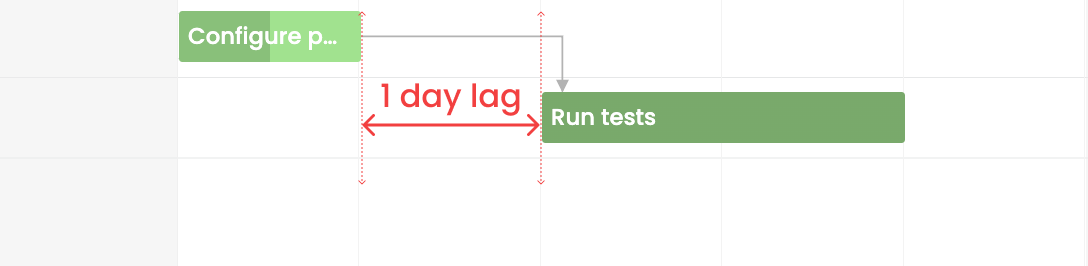

Lead (or "negative lag") will accelerate the succeeding task by the number of time units specified.
The lag value specifies the amount of working time. The calendar controlling which time to use is defined by the calendar field. By default, the successor calendar is used.
Event constraint effect on the scheduling
A task constraint defines boundaries for the schedulable date range of a task, and it is taken into account when the engine schedules the project tasks.
A constraint is a combination of two task properties: constraintType and constraintDate. The date range specified by a constraint restricts the task start/end dates to be not earlier than, not later than or equal to the provided constraintDate.
As mentioned above, a task with no restrictions is scheduled for the project start for forward projects (and on the project end date for backward projects). When a user manually drags a task in a Gantt chart, the Gantt enforces the position by setting a constraint on the task. In a forward scheduled project, it uses:
For a backward scheduled project, it uses:
How a constraint affects a task depends on its type. There are two groups of constraints available:
Inflexible constraints
There are two constraint types in this group: Must start on (MSO) and Must finish on (MFO). They force a task to start/finish exactly on the date provided.
Semi-flexible constraints
These constraints share the same priority with task dependencies. They all work together respecting the task working time:
Effectively, the task start/end dates are calculated as aggregated values considering dependencies and such constraints. The earliest start date for a task is computed as the latest of the earliest start allowed by its constraint and the earliest start allowed by its dependencies.
An example, Event A has two incoming dependencies which don't allow it to start earlier than 01/18/2017 and the task has a SNET constraint which forces it to start not earlier than 01/17/2017. In this case, the resulting earliest start date of the task is 01/18/2017. If we change the constraint date to 01/19/2017 the resulting earliest start date will be 01/19/2017.
Taking into account the project hierarchy
When scheduling tasks, the Gantt engine takes the hierarchy into account by following these two principles:
The % completed value of a parent task is calculated based on its children's progress. It is determined by dividing the sum of each child's completed duration by the total duration of all children. The completed duration for each child is obtained by multiplying its individual percentage completion value by its duration.
To explain this more, consider the following example:
It has the following values:
Next, divide the sum of the complete duration by the sum of the duration (
630/17
), which will result in 37%.FYI: calculation of % done for parent tasks can be disabled by setting autoCalculatePercentDoneForParentTasks to
false
.Following the above rules, the Gantt engine recalculates summary tasks when their children are updated. The same goes for the reverse case, child tasks will react to changes to constraints and dependencies of their parents.
Event scheduling mode
Unlike the dependencies and constraints affecting the task position on the time axis, the scheduling mode specifies how the task's properties depend on each other. It defines which properties are fixed (provided by the user) and which should be calculated.
There are four scheduling modes available in the Gantt engine:
There is also an additional effortDriven flag allowing to fix the task effort value. When set, it tells the task to preserve its effort value and instead recalculate other properties.
Normal
In the Normal mode (default), the task is scheduled based on information about its start/end dates. The task effort and assignments are not calculated in this mode.
This mode is always used for summary tasks.
The effortDriven flag is not used in this mode.
Fixed Duration
Fixed Duration mode means that the task has fixed start and end dates and duration, but its effort is computed dynamically based on the assigned resources.
A typical example of such a task is a meeting. Meetings typically have pre-defined start and end dates, and the The more people participating in the meeting, the more effort is spent on the task. When the duration of such a task increases, its effort increases, too.
Changes to the effort of such a task will cause assignment units recalculation and vice-versa (assignments change will cause recalculation of the effort).
Enabling effortDriven for a task will change that behavior and force the task to always recalculate its assignment units whenever the task changes its duration or effort.
Fixed Effort
Fixed Effort mode means that the task has a fixed effort and computed duration. The more resources are assigned to the task, the less the duration will be.
A typical example is a "paint the walls" task - several painters will complete it faster.
Enabling the effortDriven flag makes no sense in this mode.
Fixed Units
Fixed Units mode means, that task has fixed assignments and computed duration or effort.
Changes to the effort of such a task will cause duration recalculation and vice-versa (duration change will cause recalculation of effort).
Changes of the assignment of such a task will cause effort recalculation and duration recalculation if the effortDriven flag is enabled.
